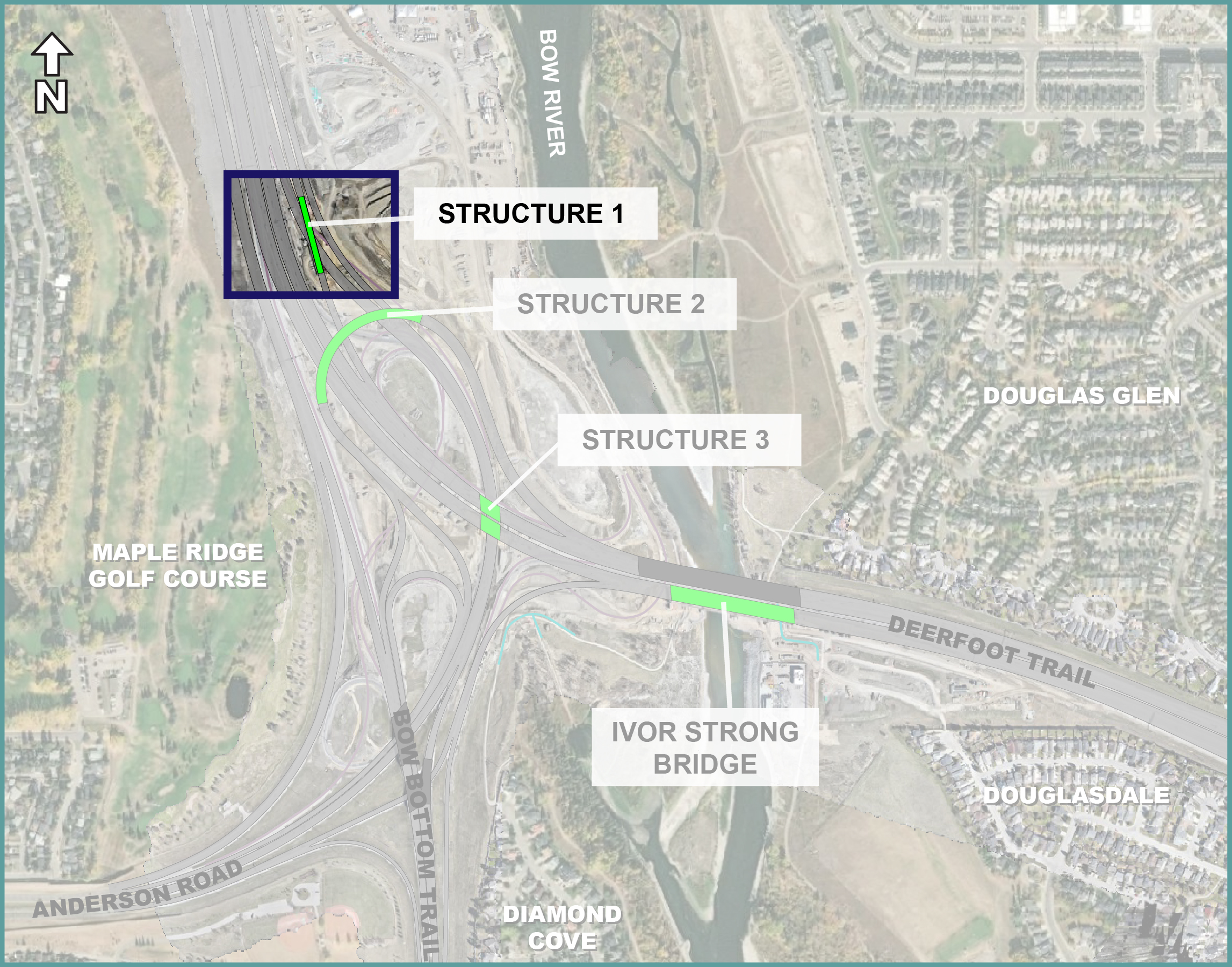

Structural Work Over the summer, work was focused on advancing bridge deck construction and surrounding roadway connections. Construction activities included installing transition and concrete safety barriers that create a smooth, secure connection between the bridge and the approaching roadway.

Looking South at Structure 1 Bridge Progress. July 10, 2026.
Bridge Deck Waterproofing and Paving Waterproofing is a protective layer that helps prevent water, road salts, and moisture from penetrating the concrete extending the bridge’s life. Waterproofing was completed on Structure 1, followed by paving work to create a smooth driving surface.
Roadworks A temporary detour was put in place in late June, as work on the subgrade (layer of compacted soil and gravel beneath the road) took place. Once the subgrade was constructed, the new roadway was paved. When paving is complete, crews will install lane markings and line painting.
Looking North at the Detour under Structure 1. June 30, 2026.

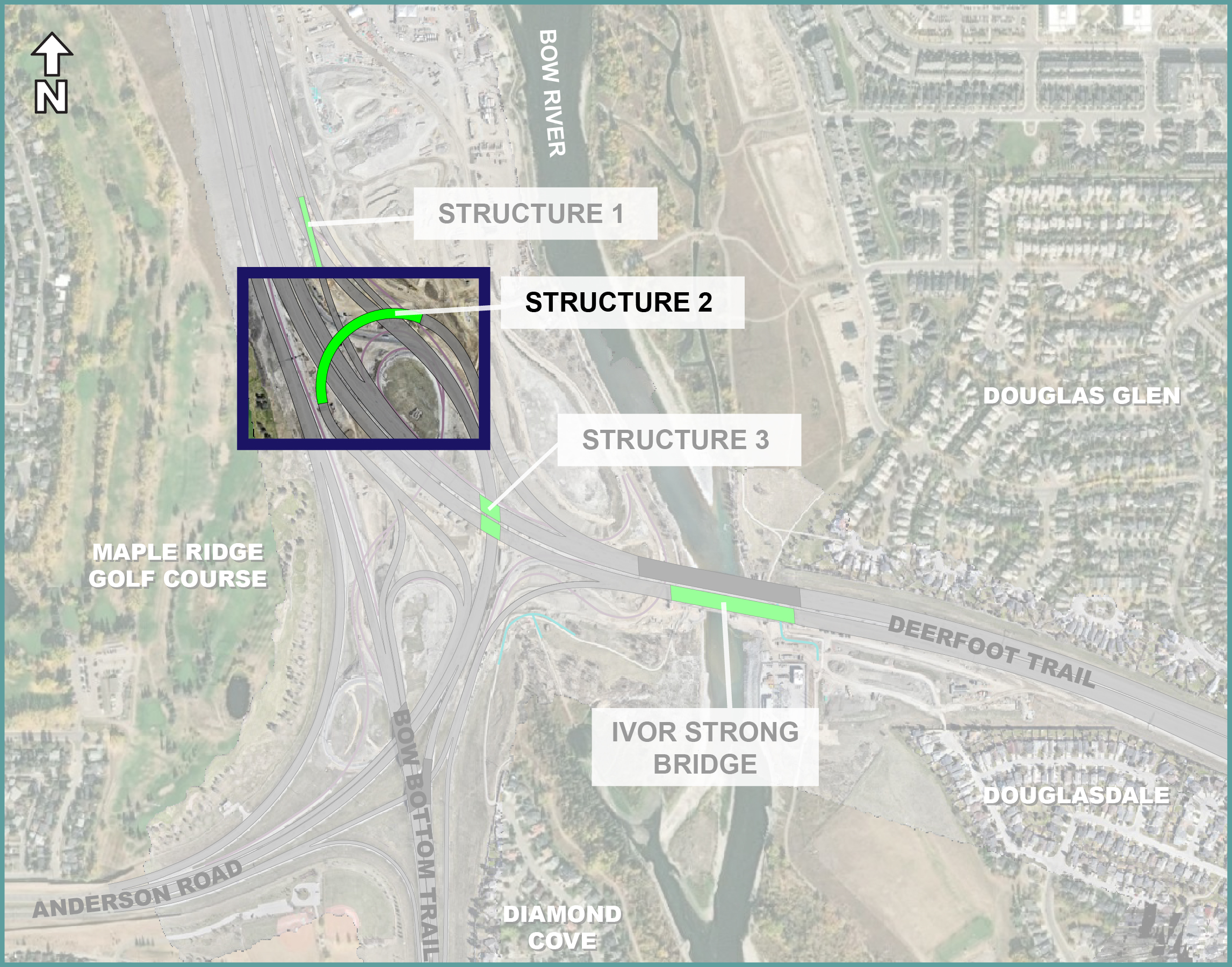

Structure 2
Bridge Deck Bridge work continues on Structure 2, with the completion of bridge deck concrete pours and work on both bridge abutments.The process involves installing steel reinforcing bars (rebar), placing shaping forms, and pouring the concrete. Safety barriers have also been installed, marking a significant milestone in the construction of this structure.
Structure 2 Night Bridge Deck Concrete Pour. June 12, 2026.
Expansion Joints and Wingwalls Work also included the east and west expansion joints, specialized connections that allow the bridge to safely expand and contract with temperature changes, as well as wingwall barriers, which help guide vehicles and support the roadway at bridge approaches.

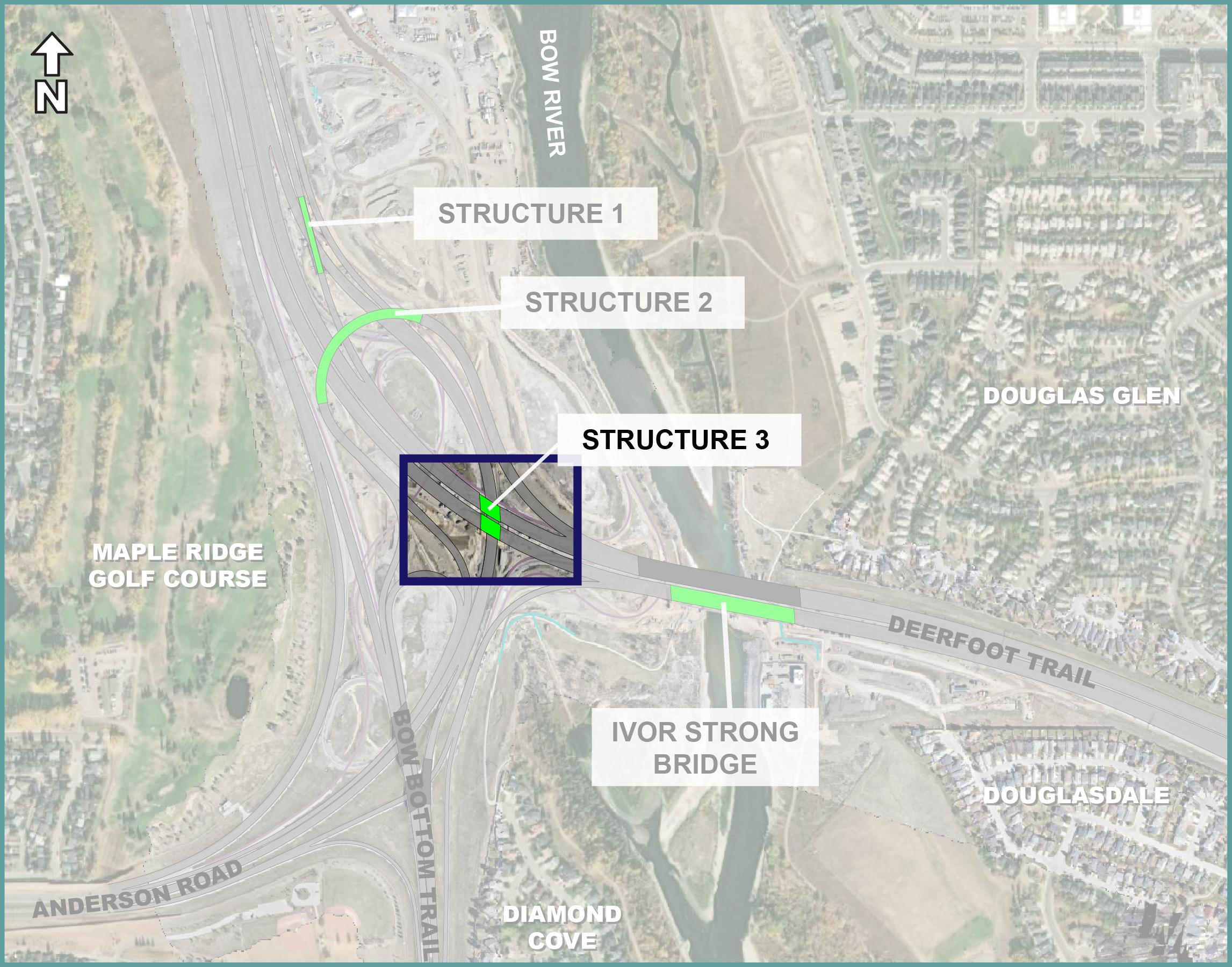

Structure 3
Structural Support Work On Structure 3, the post-tensioning of the girders with high-strength steel cables was completed. Post tensioning on bridges is a prestressing technique used to reinforce concrete components, ensuring the bridge structure is ready to handle heavy loads, enhancing the structural safety and durability of the bridge.
Work also included the east and west expansion joints, specialized connections that allow the bridge to safely expand and contract with temperature changes, as well as wingwall barriers.
Structure 3 Bridge Progress Over the Summer.
What’s Ongoing?
Structure 2
Work on this structure is currently focused on installing the expansion joints, which is expected to be completed by end of September.
Structure 3
Waterproofing and paving of the bridge deck activities are underway and are also expected to be completed in mid-September.
